PHILIPPINES · COLD STORAGE

300kW Solar System for Cold Storage in Isabela, Philippines

A 300kW solar system for a cold storage facility in Isabela — designed around compressor starting current and the cost of losing the cold chain.

Get the same resultsAll projects

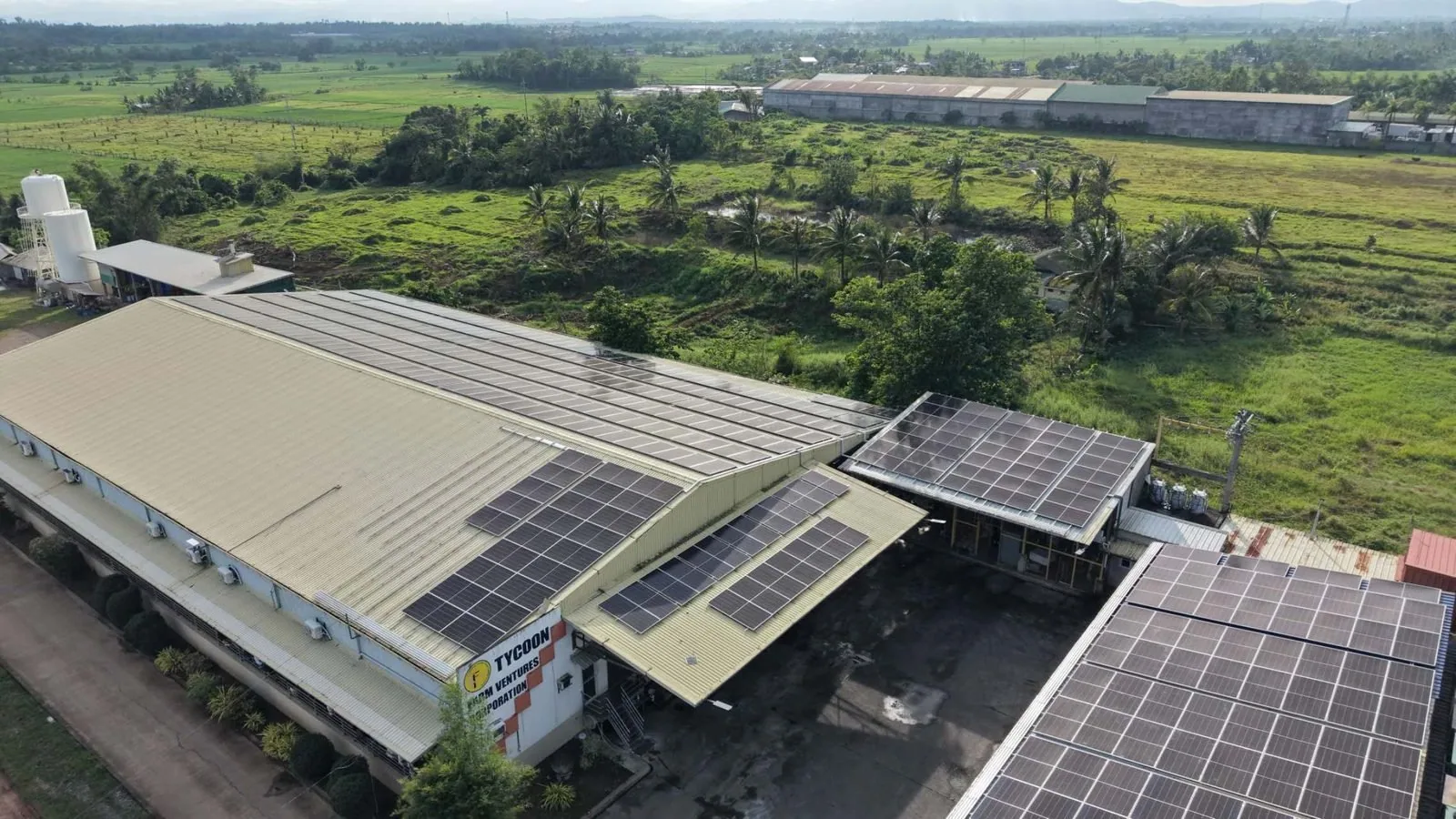

Aerial view of the cold storage facility with rooftop solar in Isabela
Capacity300 kW PV
ArchitectureOn-grid, storage-ready
ApplicationCold storage
MarketPhilippines

Project Background

Cold storage is an unforgiving load: compressors run day and night, start with a heavy surge, and the product in the rooms carries real value. This facility in Isabela province needed lower electricity cost without adding risk to the cold chain.

The site offered ample roof and adjacent land, with a grid connection that is present but not always reliable.

The challenge

Round-the-clock refrigeration load, compressor starting surges, and zero tolerance for extended outages.

The Solution

The PV array was sized to cover the heavy daytime refrigeration load, with inverter capacity checked against simultaneous compressor starts. The electrical design keeps the system storage-ready so a battery can carry outage cover in a second phase.

Cable routes and inverter placement were planned for a humid, high-uptime environment, with monitoring configured for generation and alarm tracking.

SYSTEM CONFIGURATION

What was supplied.

The configuration below is the reference for this project; every new system is sized against its own load data.

ComponentConfiguration
Solar panels≈ 550 × 550W N-type TOPCon modules
Inverters3 × 100kW, 3-phase
MountingRoof and ground sections by site layout
MonitoringRemote generation and alarm monitoring

Results & ROI

  • Daytime solar generation covers the bulk of the refrigeration load — the period when compressors work hardest against ambient heat.
  • Backup-hour targets and battery sizing were defined in the engineering phase; storage can be retrofitted without replacing the inverter platform.

Performance figures are engineering estimates from the project configuration unless stated otherwise.

Why this architecture was chosen

Why the array follows daytime load, not total consumption

The array was sized to cover the heavy daytime refrigeration load — the period when compressors work hardest against ambient heat. Sizing instead to total site consumption would have pushed PV beyond what the facility can actually consume during sun hours.

Why storage was left to phase two

The grid connection is present but not always reliable, and the site has zero tolerance for extended outages — but those two things cannot be paid for at once. Keeping the electrical architecture storage-ready means a battery can be retrofitted later without replacing the inverter platform, with backup-hour targets defined during engineering rather than guessed at quotation.

COMPONENT NOTES

Why each part was specified this way

Every quantity below is the one actually installed — nothing here is illustrative.

ComponentWhat it does on this site
≈ 550 × 550 W modules≈ 300 kW spread across roof and ground sections according to the site layout.
3 × 100 kW three-phase invertersThree machines rather than one large unit: redundancy if a unit is down, and capacity checked against simultaneous compressor starts.
Roof and ground sectionsUsing available ground avoids concentrating all array weight on the building structure.
Remote generation and alarm monitoringConfigured for a humid, high-uptime environment where nobody should be relying on a manual walk-through to find a problem.

Applying this to your site

The value in a project like this is not the equipment list — it is the sequence of decisions behind it. If your site resembles this one, these are the questions worth answering before anyone quotes a capacity.

  • Audit the compressors: quantity, running pattern and simultaneous start current. This decides inverter count more than total kW does.
  • Set the backup-hour target in writing before phase two — it is the single number that sizes the battery.
  • Check whether roof and ground are both available; spreading an array usually reduces structural work.
  • Plan cable routes and inverter placement around moisture, not convenience.
  • Keep the monitoring scope on alarms, not generation alone. A cold room losing temperature is the expensive failure mode.
  • Check what the distribution utility credits exported energy at before fixing the array size — the Philippine net metering guide works through the rate and the cap.
IMPLEMENTATION TIMELINE

From survey to commissioning.

Typical export project sequence — actual dates depend on destination and site.

Week 1–2

Load measurement and compressor audit

Week 3–4

Engineering and BOM

Week 5–8

Shipment and delivery

Week 9–12

Installation and commissioning

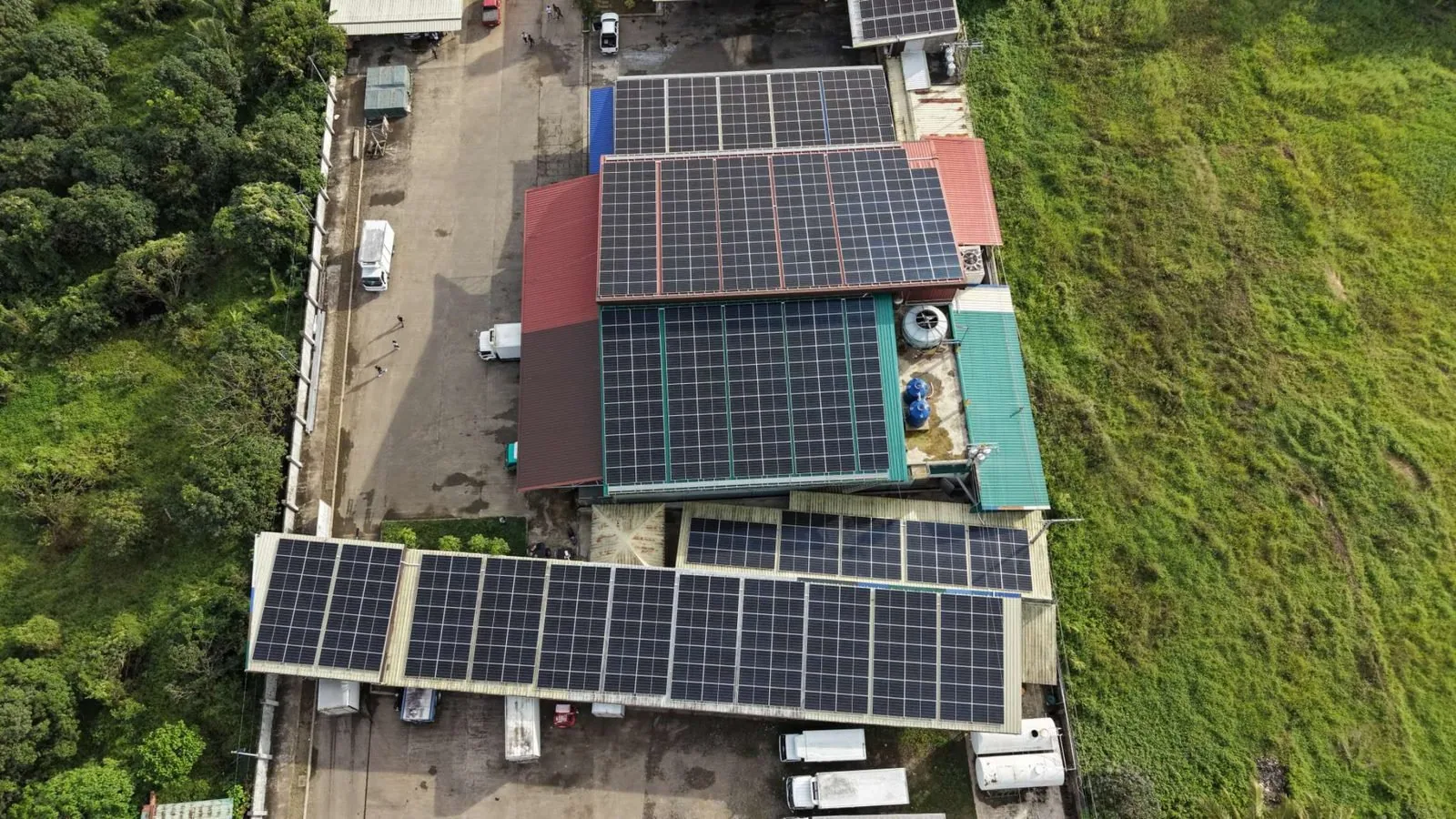

PROJECT GALLERY

Installation records.

Frequently asked questions

Why was inverter capacity checked against compressor starts?

Cold storage is an unforgiving load — compressors run day and night and start with a heavy surge. Inverter capacity was sized against simultaneous compressor starts.

What hardware was used at Isabela?

Around 550 × 550 W N-type TOPCon modules and three 100 kW three-phase inverters, mounted across roof and ground sections according to the site layout.

Is the system backed up by batteries?

It is built on-grid and storage-ready. The grid connection is present but not always reliable, and the design accounts for zero tolerance for extended outages.

How is the plant monitored?

Remote monitoring covers both generation and alarms, configured for a humid, high-uptime environment.
